Tracking Contingencies and Allowances

Contingencies in construction are funds reserved for potential risks or changes in the project scope that are not known in advance, while allowances cover known scopes of work with an unknown cost. Both are vital for budget management and can be tracked within Join.

Creating Contingencies and Allowances

Project Contingencies and Allowances

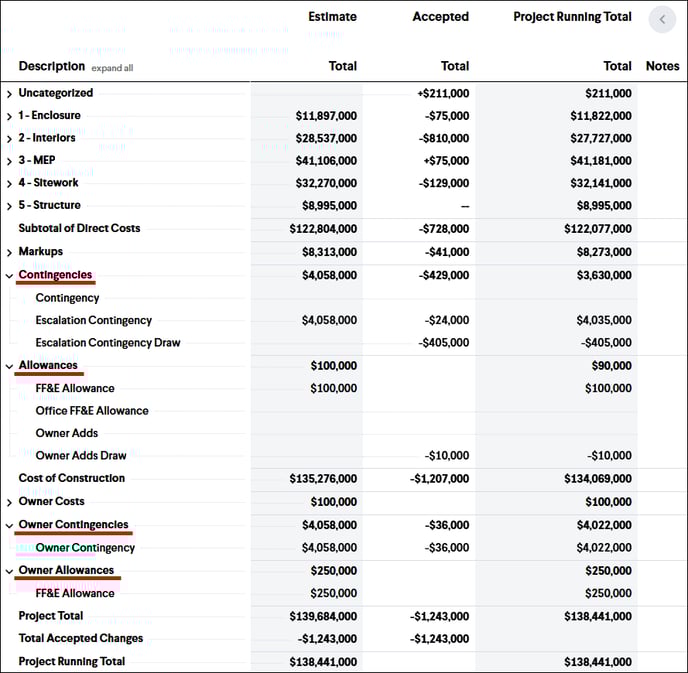

Project Contingencies and Allowances are included in the Cost of Construction and live in the Milestone Markups table of the Milestone Estimate/Budget. To create a Contingency or Allowance, add a row to the Markups table and change the Type to either Contingency or Allowance.

Owner Contingencies and Allowances

Owner Contingencies and Allowances are included in the Project Total cost and live in the Owner Costs table of the Milestone Estimate/Budget. To create an Owner Contingency or Allowance, add a row to the Owner Costs table and change the Type to either Owner Contingency or Owner Allowance. By default, Owner Contingencies and Allowances are visible and editable to project teammates with Admin and Owner role permission.

Tip: Owner costs can be displayed or hidden depending on the selected Project Costs Display settings. To display Owner Costs, select Project Total

Adjusting Contingencies and Allowances

With the Contingencies and Allowances set at the Milestone, you can now make adjustments to them through the Contingeny and Allowance Adjustments section of an Item estimate. Adjustments can be set to the full amount of an Item or a custom amount, and they can be split across multiple Contingencies and Allowances. Positive adjustments can also be made when an item's cost is a reduction in scope or when you choose to increase the value of a Contingency or Allowance.  When the status of the Item is changed to Accepted, the adjustment will be updated in the Contingency & Allowance Report.

Contingency and Allowance Reporting

Items List

When an Item has a Contingency or Allowance covering the item's Full Estimate, the cost impact of the Item will be zero when the cost display mode is set as Markups Allocated or Markups Separated. The net value will be displayed if the adjustment value is more or less than the Item Estimate. In the Items list, you can see the value of the Contingency or Allowance using the Item Sidebar

Tip: You can also see an Item's direct cost impact by changing the Markup Display Setting to Direct Costs Only.

MSR and Variance Report

In the Milestone Summary Report and Variance Report (depending on the display cost settings), there are sections for Markups, Contingencies, and Allowances. Positive adjustments appear as Adds, and negative adjustments appear as Draws.

Contingency & Allowance Report

From the Reports page, you can launch the Contingency & Allowance Report. You can view the adjustments in the active Milestone and across all Milestones to understand how much of the contingency or allowance you have remaining.

Running Total Estimates

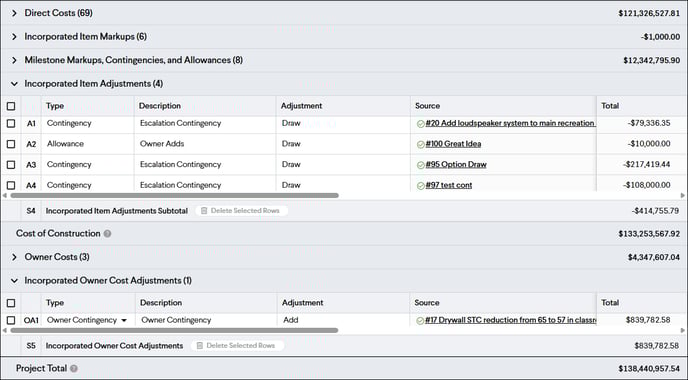

If you're copying a Running Total forward to a new Estimate or Budget, the accepted Items that have Contingency and/or Allowance adjustments will be carried over and listed as a Draw or Add in separate tables titled Incorporated Item Adjustments and Incorporated Owner Cost Adjustments. Here you can reconcile the values of contingencies and allowances with this new Milestone.
